U.S. Built Custom Bicycles in Titanium and Titanium-Carbon Mix
As of 26 September 2024
Our estimated lead time can change quickly, based on unpredictable variables. Make sure you order your bike now to lock in our current lead time.
Frameset Type | Design Time, typical[1] | Build Time, estimated[2] | Frameset Total Lead Time, estimated[3] | Complete Bike Lead Time, estimated[8] |
---|---|---|---|---|
A-Frame[6] Series frames & bikes | Not Applicable | 1 week | 1 week[6]
Current frame price: $2,995[7] |
5 weeks |

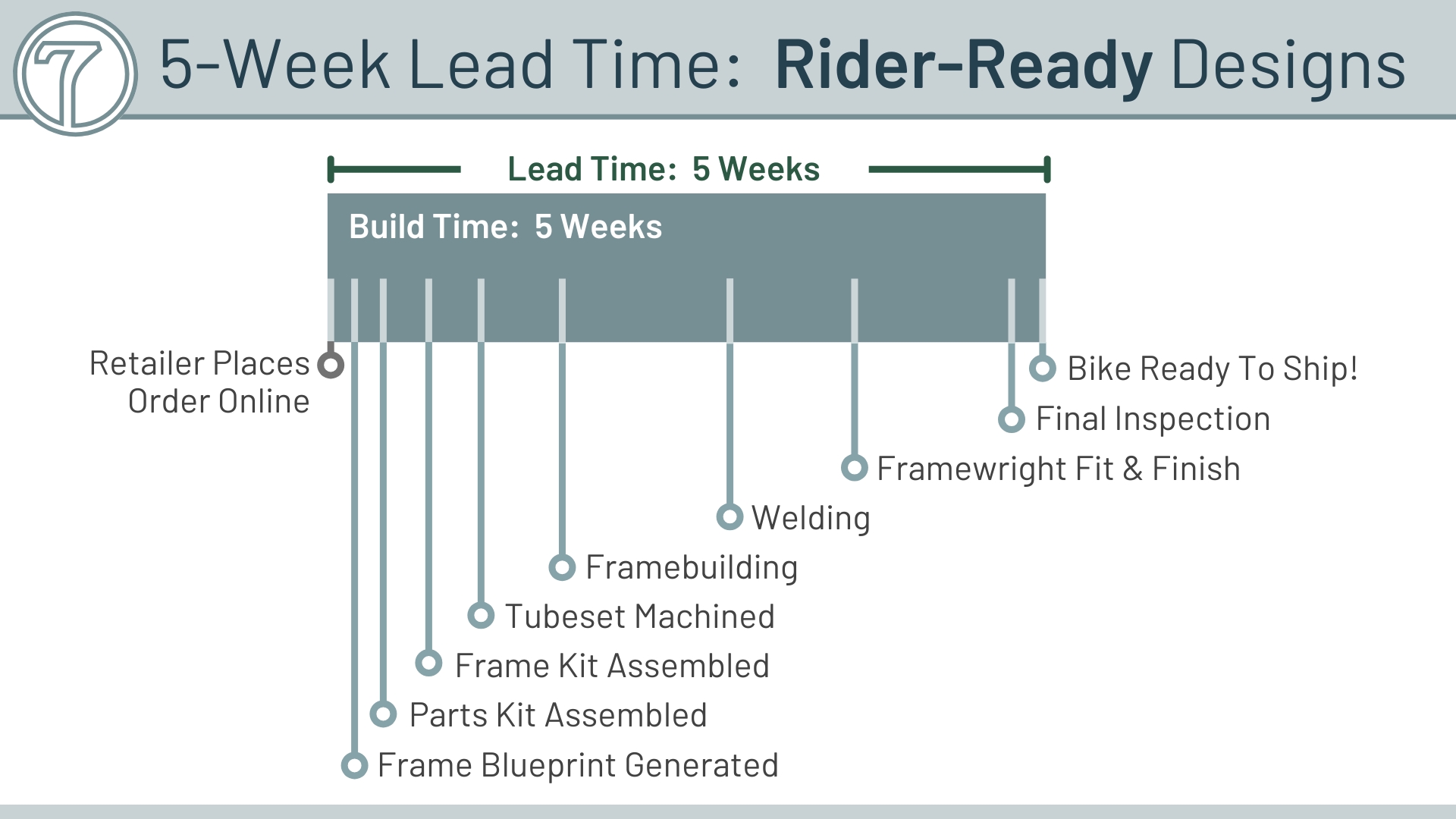

Rider-Ready Designs[4] | Not Applicable | 1 weeks | 1 weeks | 5 weeks |
Full custom unpainted frames & bikes | 2 weeks | 5 weeks | 7 weeks | 7 weeks |
Painted unsuspended | 2 weeks | 7 weeks | 9 weeks | 9 weeks |
Suspension bikes[9] | 3 weeks | 10 weeks | 13 weeks | 13 weeks |
Suspension bikes, painted[9] | 4 weeks | 12 weeks | 16 weeks | 16 weeks |
One of the true innovations Seven cycles has brought to the bike industry is the idea that you can have a bike built-to-order faster than ever before – faster in many cases than the time it takes to obtain a production bike. By harnessing the flexibility of our manufacturing system, Seven provides the highest quality, most customized rider experience possible and can offer that experience in whatever timeframe you prefer.
Build time refers to the length of time between when you've placed your deposit and confirmed your bike design and when your bike is ready to ship. We start the clock once Seven is in full control of the timeframe — which is after you've signed off on what you want Seven to build. If the clock was ticking and you are still making design decisions, Seven has no control over this, and it may incent you to rush the process. You should take your time in making bike decisions; once those decisions are made, then it's Seven's job to meet timeframe expectations.
When we provide a lead time, design time, or build time, it is our best estimate at the time we offer the date. There are a number of reasons we do not guarantee this date. The custom framebuilding process is complicated. The craft of building a frame from raw materials by hand is not a production process we can predict to the hour. The work takes the coordination of a dozen people and suppliers. Some custom frames are more complicated than others. Sometimes an employee takes a day off. Sometimes the humidity in the air slows the paint process.
We take the estimate we provide seriously. However, if we are a few days behind on the initial estimate we provided you weeks ago, we ask for your patience. When you do receive your one-of-a-kind handbuilt Seven, it will serve you well for years or decades.
We publish current build times on our website because seasonality and changes in demand impact the way build time is calculated. Depending on a number of factors, build times can increase or decrease. During peak times of the year, our build times increase as a function of the number of orders we receive. We make modifications to staffing and processes in order to optimize workflow and reduce build times, but often during Spring and Summer in North America, we will experience demand that exceeds the limits of our production system. We publish lead times, build times, and design times to help set expectations and also let everyone know how competitively we can deliver built-to-order products.
Regardless of the time of year, if you have an important race, trip, or other special event coming up, let us know, and we can work with you to meet your delivery needs.
Lead time refers to how long it takes Seven to handcraft your frame and Seven branded components and have it ready to ship. This figure does not include:
To minimize total delivery time, you can ask for expedited shipping or bike assembly. Additional charges may apply. Please contact your local Authorized Seven Retailer for details.
